Skip to main content
Edit the parent, save, and the change goes to every linked project. Not instantly, and the reason matters.

It happens in the background, on purpose

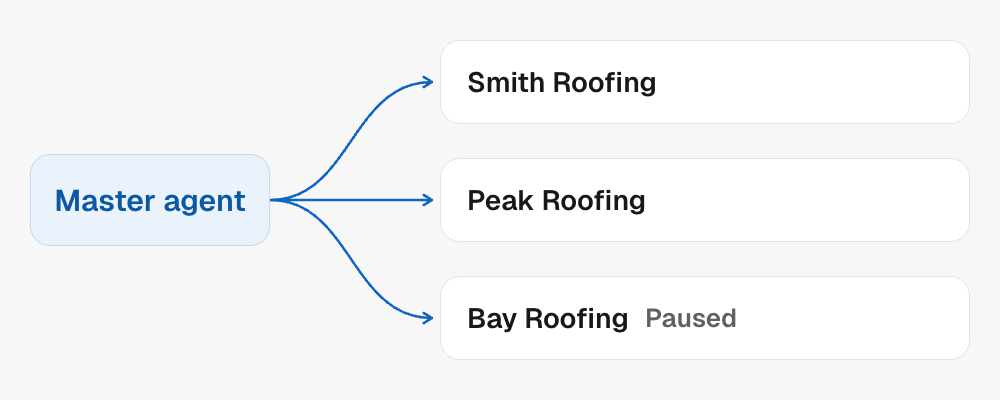

Save the parent, then let the updates finish in the background. You can keep working while linked projects catch up. You save the master agent once, and each client updates in turn. Bay Roofing is paused, gets the update, and stays paused. You save the master agent once, and each client updates in turn. Bay Roofing is paused, gets the update, and stays paused. If a project cannot be updated, the system retries it. If you save another change while an update is in progress, the latest version takes priority. Project Manager flags a project whose update failed.
So “I changed it and that client has not got it yet” is usually a question of seconds, not a fault. The update job checks for new saves every 30 seconds.

Two things a rollout will not do

It will not overwrite a binding. A calendar, pipeline stage or transfer number that is set on a project stays set. See bindings. It will not switch anyone on. Live status is per project. Rolling out a change to a paused project leaves it paused.

Adding a step to the flow

When you add a node to the parent that needs a local asset (a booking action, a Move Stage), it reaches the children unbound. That is the safe outcome, not a bug. The alternative is every project inheriting the parent’s calendar ID and booking into one sub account. Expect those projects to show as needing attention afterwards, and expect to connect the new asset on each. Adding a booking step to a thirty-client master agent is thirty small bindings, and there is no way around that which is also safe.

When a change genuinely has not landed

Work down this list:
1

Is it actually a shared field?

Calendars, transfer numbers, pipeline stages, phone numbers and live status are local by design. Check what syncs before treating it as a failure.
2

Is that project still linked?

An unlinked project keeps its campaign and simply stops receiving updates.
3

Is the project simply switched off?

A rollout never switches anyone on. A paused project receives the change and stays paused, so the change is there and nothing is calling.An unresolved binding looks similar but is not the same thing: it blocks go-live, not the sync. That project has your change; it just cannot be activated until its calendar or pipeline is connected.
4

Did the call actually happen?

Run history on that project answers what ran, as opposed to what is configured.

In the API
